IoT app development runs from roughly $58,000 to over $500,000, and takes four to twelve months. But budget is rarely the reason IoT programs stall. The bigger risk is the timeline: hardware iteration, FCC certification, and industrial protocol integration often sit on the critical path long before the mobile application is ready.

A vibration-monitoring rollout across 500 machines may complete its AWS IoT Core backend in eight weeks, only to wait another eleven weeks for radio certification. That gap between software readiness and physical deployment is where many IoT initiatives lose executive momentum.

McKinsey found that companies fail to capture value from 70 percent of their Industry 4.0 pilots (McKinsey, 2018).

This guide covers three things. First, the four architecture layers and how each one sets your cost. Second, what four common deployment tiers run. Third, a phase-by-phase timeline showing exactly where schedules slip. It is written for operations and engineering leaders in manufacturing and logistics. Every figure carries its source and its date.

Key Takeaways

  • IoT app development runs $58,000 to over $500,000 and takes four to twelve months.
  • Schedule risk matters more than budget risk on a connected-device build.
  • Four architecture layers set both cost and schedule: device and firmware, connectivity, cloud backend, application.
  • Hardware iteration and radio certification sit on the critical path more than the mobile app does.
  • The IoT Delivery Clock breaks the build into seven phases with named slip causes.
  • Phases three, four, and five can run in parallel, the biggest lever on total duration.
  • Pilot-to-fleet rollout gets its own budget line and duration in this framework.
  • Off-the-shelf, pre-certified hardware cuts certification from months to weeks wherever it fits.

What IoT App Development Involves

IoT app development, or internet of things app development spelled out in full, builds four connected systems that work together as one product.

Device firmware, the connectivity layer, the cloud backend, and the application people use make up those four systems. Traditional mobile app development covers only the last two.

The first two add hardware iteration, radio certification, and field conditions to the project. They set most of the schedule, which is the theme running through this whole guide.

The industrial segment of this market is projected to reach 1.69 trillion dollars by 2030, per Grand View Research. That scale is why I walk every client through the schedule risk below before we talk features.

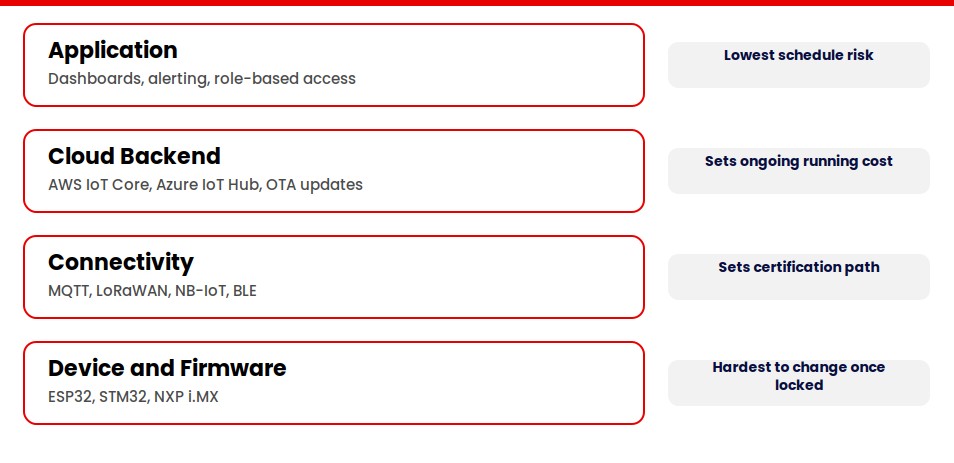

The Four Layers of an IoT Architecture

Four layers make up every IoT system, and each one locks in a cost and schedule decision before you notice it happening.

Device and firmware. Microcontrollers such as ESP32, STM32, and NXP i.MX handle sensing and control. Firmware decisions here are the hardest to change once certification starts. I have seen a client swap a sensor vendor mid-build because of a supply issue, and it cost them six weeks of re-certification they had not budgeted for.

Connectivity. MQTT and CoAP handle lightweight messaging. LoRaWAN, NB-IoT, and LTE-M cover long-range and cellular links, while Zigbee and BLE cover short range. Protocol choice sets both the carrier cost and the certification path. That certification consequence is worth planning around early.

Cloud backend. The backend ingests, stores, and routes telemetry. AWS IoT Core and Azure IoT Hub are the two platforms named on nearly every iot application development platform shortlist. Both handle device provisioning, message routing, and OTA firmware updates.

Application. The application layer is the dashboard or mobile app people use. It is the layer buyers understand best, and in my experience it rarely drives the schedule.

This is where iot software development decisions lock in. Swapping a protocol after hardware is chosen restarts prototyping entirely.

Connectivity choice also shows up in connected vehicle and fleet telematics work. LTE-M and cellular links dominate there over short-range protocols.

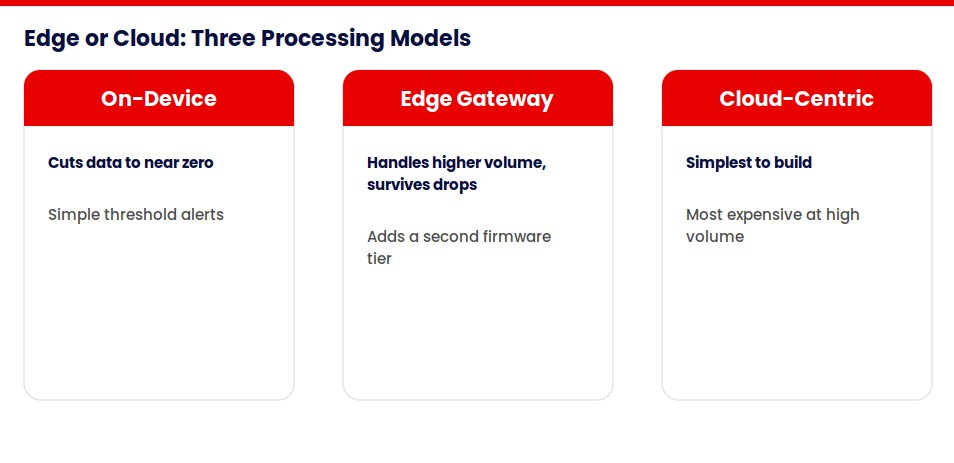

Edge or Cloud: The Decision That Sets Your Running Cost

Edge or cloud is the decision that sets your ongoing running cost more than any other architecture choice.

On-device. Processing runs directly on the sensor or microcontroller. It cuts data volume to almost nothing and works well for simple threshold alerts.

Edge gateway. Processing runs on a local gateway before anything reaches the cloud. It handles higher data volume than on-device processing and keeps working through a connectivity drop.

Cloud-centric. Raw telemetry goes straight to the cloud backend for analysis. It is the simplest model to build and the most expensive to run at high data volume.

This decision also gates hardware selection, and hardware selection gates certification timing. Every iot application development project should settle this question in discovery, before hardware gets ordered. Choosing the processing model late restarts the hardware conversation.

The Operator App: What the People Using It Need

The operator app needs four things regardless of industry: dashboards, alerting, role-based access, and offline behavior.

I see clients spend the most scoping time on this layer. It carries the least schedule risk of the four. iot mobile app development gets the most attention in early conversations and the smallest share of the actual timeline.

The operator app is built on the device and connectivity decisions above it. Locking the interface before those decisions are final is the most common source of rework I see in this layer.

Connecting to What You Already Run: ERP, SCADA, and MES

Modbus and OPC-UA are the two protocols that connect an IoT system to existing plant equipment.

A gateway translates between the plant-floor protocol and the cloud-native protocol the new system speaks. custom software development for iot almost always includes this gateway translation layer, and estimates that skip it run short.

This translation work is the line item that surprises manufacturers. It depends on equipment installed years before the IoT project started. I have scoped builds where the plant’s PLCs were installed before Modbus even had a TCP variant, and the gateway work alone ran longer than the firmware.

software development for iot differs most from a typical mobile build right here. The boundary sits with equipment nobody on the software team chose.

For logistics and supply chain systems, this gateway layer connects to a warehouse management system or an existing ERP. The same translation problem shows up there too.

What IoT App Development Costs by Deployment Tier

Iot app development cost runs from about $58,000 for a single-site deployment to over $500,000 for a multi-site platform. Device count drives it more than feature count does.

Deployment Type Device Count Build Cost Range Time to First Production Device What Drives the Top of the Range
Pilot or proof of concept 10 to 50 ~$25,000–$75,000 3–6 months Custom sensor combinations and non-standard field conditions
Single-site monitoring 50 to 500 ~$58,000–$150,000+ 6–9 months Number of distinct sensor types and integration depth with existing equipment
Multi-site industrial 500 to 5,000 ~$150,000–$500,000+ 9–15 months Site-to-site connectivity variation and provisioning complexity
Fleet or enterprise platform 5,000+ $500,000+ 12–18+ months Regulated data handling, multi-region certification, and fleet-wide OTA infrastructure

Our own estimation work on how we estimate software project cost puts a comparable software-only build at $40,000 to $200,000. The IoT premium sits almost entirely in hardware, connectivity, and certification. The software layer costs comparatively little on its own.

If you want a fast baseline before a full scoping conversation, our app cost calculator gives a starting estimate. You can adjust it as your device count firms up.

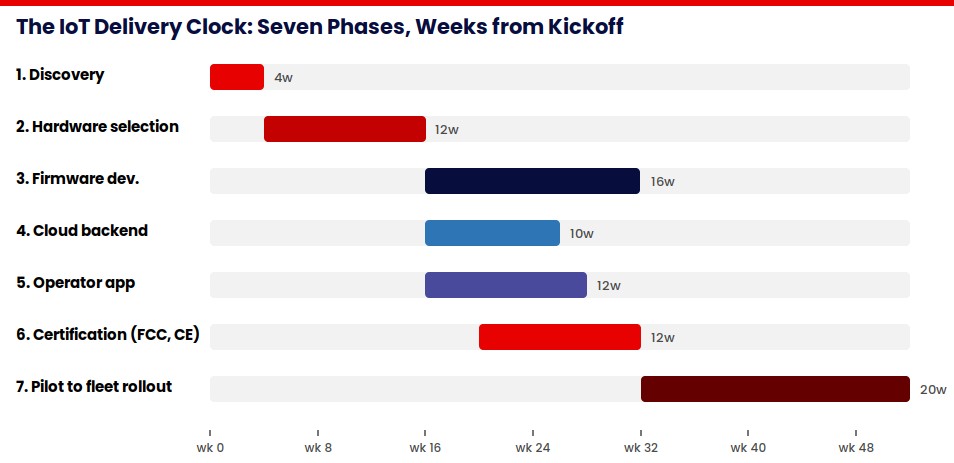

The IoT Delivery Clock: How Long Each Phase Takes and What Makes It Slip

The IoT Delivery Clock breaks a build into seven phases. Hardware and certification gate the schedule.

Phase Duration What Gates It Most Common Slip Cause
1. Discovery and architecture 2 to 4 weeks Device count, environment, existing OT systems Nobody can say what protocols the existing equipment speaks
2. Hardware selection and prototyping 6 to 12 weeks Two to three prototype rounds Bench behavior differs from field behavior under heat and vibration
3. Firmware development 8 to 16 weeks Runs parallel to cloud work Custom driver work for a non-standard sensor
4. Cloud backend and data pipeline 6 to 10 weeks Runs parallel to firmware Telemetry volume estimated low, schema reworked
5. Operator application 6 to 12 weeks Gated by the backend timeline Rarely the constraint
6. Certification (FCC, CE) 6 to 12 weeks Lab availability, outside team control First submission fails and the lab cannot reschedule quickly
7. Pilot to fleet rollout 8 to 20 weeks Site access and provisioning throughput Connectivity varies by site and nobody surveyed for it

The critical path runs through hardware selection, certification, and pilot rollout, in that order.

Phases three, four, and five, firmware, cloud backend, and the operator app, run in parallel. Certification can start once the hardware design is locked at the end of phase two. That is the concurrency window most schedules waste.

US devices with a radio go through the FCC’s equipment authorization process. Most use the Supplier’s Declaration of Conformity route for Part 15 devices. EU market entry runs through CE marking.

Connected devices now also fall under the Cyber Resilience Act, which adds vulnerability-reporting and support-period obligations. Those sit on top of the existing safety requirements.

When a client tells me their pilot works and production is six weeks out, I ask what lab is running their FCC certification and when it was booked. That answer tells me more about the real date than the pilot does. Certification is the phase clients underestimate almost every time, because a lab’s calendar decides the pace, and no engineering team can accelerate that calendar.

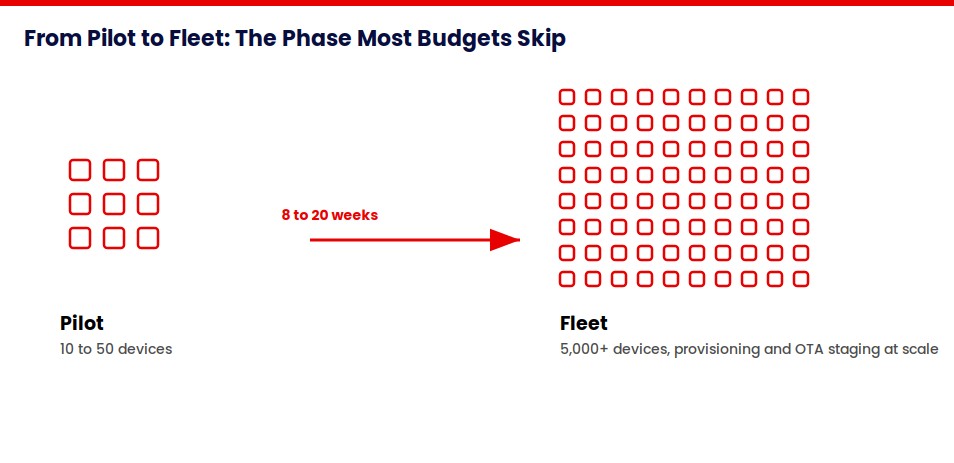

From Pilot to Fleet: The Phase Most Budgets Skip

Pilot-to-fleet rollout is its own costed, durated phase, and most IoT budgets never plan for it as one.

The pilot-purgatory pattern cited earlier plays out here specifically. A pilot proves the technology works in controlled conditions with a handful of devices. Production requires provisioning thousands of devices, managing firmware across a fleet, and handling sites with different connectivity.

Pilots rarely budget for any of that. Treating rollout as its own phase, with its own schedule and its own line item, is what prevents the stall. That stall is what most IoT programs hit after a pilot succeeds.

The closest build I can point to for this specific problem involved unattended kiosks across many healthcare facility sites for Collaborative Patient Care Group. Each kiosk needed remote provisioning, centralized scheduling, and status visibility without a technician on site.

That project shares the real planning problem behind this section: provisioning, monitoring, and supporting a large number of unattended, distributed endpoints without flying someone to every location. Hardware categories vary from build to build. This scheduling and provisioning problem stays constant across all of them.

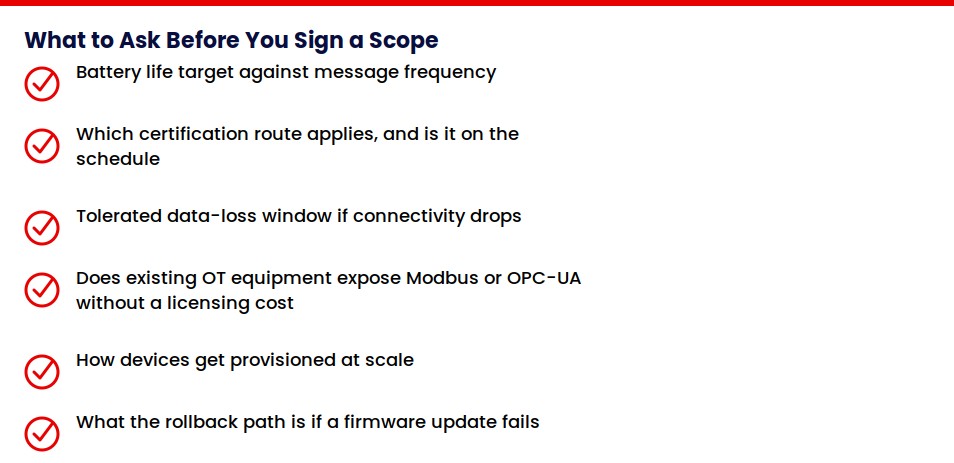

What to Ask Before You Sign a Scope

These eight questions surface whether a vendor understands your hardware and certification path before you sign anything.

  • What is the target battery life against your expected message frequency?
  • Which certification route applies to this device, and is it on the project schedule?
  • What data-loss window is tolerated if connectivity drops in the field?
  • Does your existing OT equipment expose Modbus or OPC-UA without a separate vendor licensing cost?
  • How do devices get provisioned once you move past pilot scale?
  • What is the rollback path if a firmware update fails in the field?
  • Which phase in the schedule is the one most likely to slip, and why?
  • Has the vendor shipped a comparable device count before, or only pilots?

I ask these same questions on every iot app development services engagement I scope, and internally too, before our own team commits to a date. A strong answer names a specific certification lab and a booking date. A vague answer names only the certification type. That gap tells me whether a schedule is real or a guess.

Wondering how much IoT apps cost?

Explore the key factors that influence IoT app development costs.

Calculate Your App Cost →

Conclusion

IoT is an architecture decision before it is a development decision. The layer choices you make in discovery set your cost, your certification path, and your schedule. Software is the part you can compress. Hardware and certification run on fixed calendars of their own. If you know your device count, your operating environment, and what your existing equipment speaks, a scoping conversation can turn those into a real architecture and a real date.

Ready to scope your IoT build?

Our engineers start with architecture and certification before writing app code.

Start Building Your Custom Solution →

If you want a second opinion on scope before you sign anything, our IoT development team can walk through these same questions against your architecture.

Frequently Asked Questions

Most enterprise IoT builds take four to twelve months from kickoff to first production device. A pilot can ship in six to ten weeks. The gap comes from hardware and certification, which run on their own calendar. Firmware, cloud, and app work overlap. Radio certification runs six to twelve weeks and depends on lab availability. Pilot-to-fleet rollout adds another eight to twenty weeks.

The ranges run from about $58,000 for a small single-site deployment to over $500,000 for a multi-site platform. Device count drives cost more than feature count. Hardware, connectivity, and certification often exceed the software budget. Ask any vendor to break out firmware, device certification, and carrier fees separately. Estimates that omit those layers are incomplete.

IoT development is the work of building four connected systems that operate as one product. Those systems are the device firmware, the connectivity layer, the cloud backend, and the application people use. Traditional app development covers only the last two. The first two add hardware iteration, radio certification, and field conditions to the project.

Off-the-shelf devices with pre-certified radio modules are faster and cheaper wherever they meet your requirements. They cut certification from months to weeks. Custom hardware becomes necessary when you need a specific form factor, sensor combination, or field life. Decide this in discovery. Changing it later restarts prototyping and certification together.

Process at the edge when data volume is high or connectivity is unreliable. Process in the cloud when volume is low and analysis matters more than latency. Edge gateways cut cloud ingestion costs substantially in telemetry-heavy deployments. The tradeoff is gateway hardware and a second tier of firmware to maintain. Decide before selecting hardware.

Most stall for operational reasons. A pilot proves the technology works in controlled conditions. Production requires provisioning thousands of devices, managing firmware across a fleet, and handling sites with different connectivity. Pilots rarely budget for any of that. Treating rollout as its own phase, with its own schedule, prevents it.
