ERP benchmarks show licensing typically accounts for only 15–25% of total first-year Dynamics 365 cost, while most spend goes into implementation services, integrations, and data migration.
Across real deployments, 30–50% of projects face delays or budget overruns, mainly due to poor data quality, unclear ownership, and underestimated integration complexity.
For organizations evaluating Microsoft Dynamics for their operations, the key is not features, but understanding real implementation cost, timelines, and where execution risk is most likely to emerge.
We review your scope, data structure, and integrations to identify execution gaps early.
Review PlanIn vendor discussions, implementation is often described as a structured sequence:
Configure ➝ migrate ➝ test ➝ go live
In real environments, it is iterative.
What typically happens instead:
This is why Microsoft itself discourages large waterfall-style ERP deployments and promotes iterative value delivery through its Success by Design framework.
Dynamics 365 implementation varies by deployment model. Cloud deployments are typically faster and easier to scale with automatic updates, while on-premises setups require more infrastructure planning, manual maintenance, and higher internal effort.
In one mid-market Finance and Operations rollout pattern I have seen repeatedly, the project plan looks stable until data migration begins. At that stage:
What looked like a configuration project becomes a data and process correction exercise.

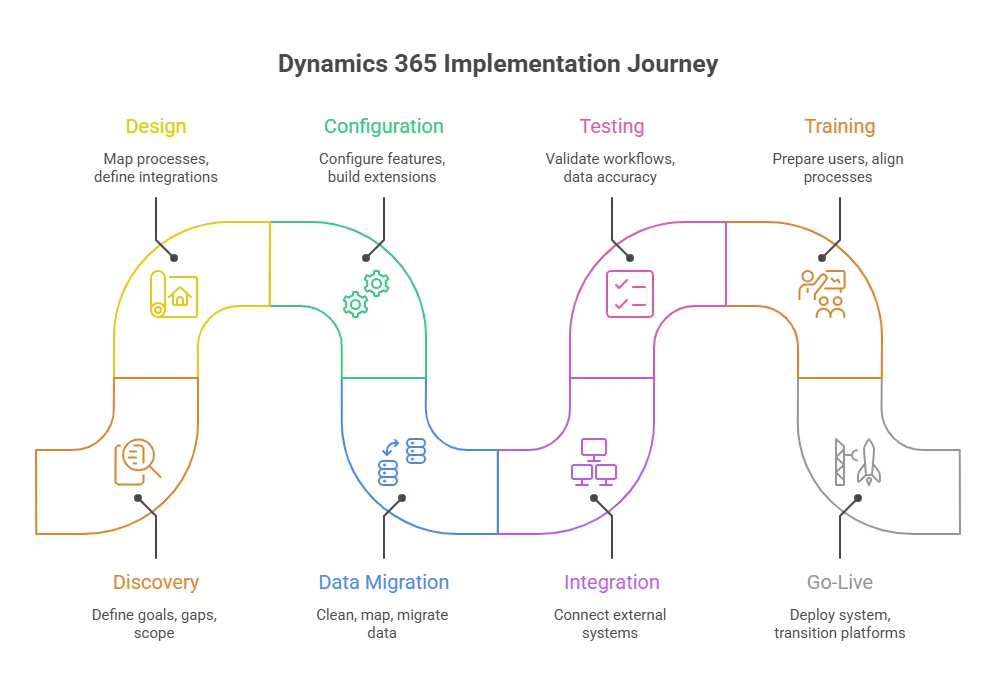

To understand how implementation actually progresses in real environments, it helps to break it down into clear, sequential phases, even though execution is rarely strictly linear.
1. Discovery and assessment
Define business goals, system gaps, and implementation scope. Most cost and timeline assumptions are set at this stage.
2. Solution design and architecture
Map business processes to Microsoft Dynamics 365 modules, define integrations, and design the data model.
3. Configuration and customization
Configure standard features and build extensions where required. Scope expansion typically starts here if not controlled.
4. Data migration
Clean, map, and migrate legacy data. This is often the most time-consuming and error-prone phase.
5. Integration development
Connect external systems such as payroll, banking, logistics, and CRM platforms. Complexity often increases during testing.
6. Testing (UAT and system validation)
Validate workflows, integrations, and data accuracy. Most design gaps are identified at this stage.
7. Training and change management
Prepare users and align processes. Adoption success is largely determined here.
8. Go-live and cutover
Deploy the system and transition from legacy platforms. Execution quality impacts early stability
9. Post-go-live support (hypercare)
Stabilize operations, resolve issues, and optimize performance during the first 30–90 days.
Industry benchmarks show a consistent gap between planned and actual delivery timelines. Smaller projects often appear fast in planning but expand during execution.
| Organization Type | Expected Timeline | Realistic Timeline | Key Delay Drivers |
|---|---|---|---|
| SMB / Business Central | 8–12 weeks | 3–6 months | Data cleanup, reporting gaps, training |
| Mid-market multi-module | 3–4 months | 4–9 months | Integration design, UAT rework |
| Enterprise Finance + Supply Chain | 6–9 months | 9–14+ months | Multi-entity complexity, governance delays |
In most delayed programs I have observed, the issue is rarely configuration effort. The primary causes are:
Migration from legacy Microsoft systems, such as Dynamics GP or NAV introduces additional complexity that is often underestimated.
From practical rollout patterns:
Microsoft’s own migration guidance emphasizes readiness assessment, environment preparation, replication, and validation steps, all of which extend timelines beyond initial expectations.
If I compress everything I’ve seen across Dynamics 365 programs into a single decision lens, it is this:
| Module | User Price / Month |
|---|---|
| Business Central Essentials | $80 |
| Business Central Premium | $110 |
| Dynamics 365 Finance | $210 |
| Dynamics 365 Supply Chain Management | $210 |
| Dynamics 365 Sales Professional | $65 |
| Dynamics 365 Sales Enterprise | $105 |
| Dynamics 365 Sales Premium | $150 |
| Company Size | Directional Implementation Range (Services Only) | Typical Dynamics Pattern |
|---|---|---|
| Small business | $25K–$75K | Business Central, limited integrations |
| Mid-market | $75K–$250K | BC Premium or phased Finance / Sales |
| Large enterprise | $250K–$750K+ | Multi-entity Finance + Supply Chain + CRM |
Hidden costs mainly come from data migration, integrations, partner effort, and user adoption rather than licensing.
The breakdown below shows where budgets typically expand beyond initial estimates:
| Cost Layer | What It Includes | Reality Check |
|---|---|---|
| Software licensing | User subscriptions, base/attach licenses | Visible; often anchors the budget discussion |
| Partner consulting | Discovery, design, configuration, PM, testing | Usually the largest cost bucket |
| Data & migration | Cleansing, mapping, ETL, mock loads, validation | Common source of overruns |
| Integrations | APIs, middleware, connectors, monitoring | Consistently underestimated in early scoping |
| Adoption | Training, change management, hypercare | Often underfunded; paid for later through poor utilization |
| Ongoing extras | Support plans, Power Platform, ISV apps, Copilot credits | Can materially increase TCO in year 2–3 |
Different ERP platforms distribute cost differently across licensing and implementation effort. This is why total cost of ownership (TCO) varies significantly even when per-user pricing looks similar on paper.
| Platform | License Signal | Implementation Signal | Cost Shape |
|---|---|---|---|
| Dynamics 365 | BC $80–$110; Finance/SCM $210; Sales $65–$150/user/mo | $30K–$2M | Modular; grows with apps and integrations |
| Oracle NetSuite | Market estimate from ~$99/user/mo + platform fee | $25K–$750K | More packaged for mid-market; modules add up quickly |
| SAP S/4HANA Cloud | Market estimate ~$180/user/mo (public cloud) | $75K–$500K (public cloud) | Standardized public edition; private edition adds flexibility and cost |
Map the hidden and visible cost drivers in your Dynamics 365 rollout to reduce overruns during execution.
Check Cost RealityAcross implementations I have reviewed or observed, failure usually follows five repeatable patterns:

Poor master data is the most consistent failure trigger. Duplicate records, inconsistent structures, and missing ownership lead to:
Most organizations underestimate how many systems actually connect to ERP and CRM.
Typical integration pain points include:
ERP projects often expand beyond original scope during testing and validation phases. This leads to:
In fact, In most cases, scope expansion is one of the most common causes of ERP overruns.
Partner capability is often the most underestimated success factor. Weak execution typically shows up as:
Even technically successful deployments fail when users do not adopt the system.
Common symptoms:
Microsoft explicitly emphasizes continuous training and adoption as part of post-go-live success, but this is often underfunded.
Immediately after go-live, support requests spike due to:
Even well-tested systems experience this because real-world usage exposes edge cases that testing cannot fully simulate.
The first month-end close is often the most critical stress test.
Common issues include:
Many finance teams report that the first 1–2 closing cycles take significantly longer than pre-implementation benchmarks.
A pattern I repeatedly observe is partial regression:
This is not resistance alone. It is often a coping mechanism for unfamiliar workflows.
Once stability improves, organizations start identifying:
This is where Dynamics 365 starts delivering measurable ROI, but only if adoption has stabilized.
A go-live checklist ensures that Dynamics 365 transitions from project state to operational state without breaking critical business processes.

A capable partner does more than configuration. They:
Weak partners tend to focus only on configuration tasks, which leads to downstream instability.
Before selecting a partner, I recommend validating:
A recurring misconception is that lower-cost partners reduce total cost.
In practice:
So, the total cost of ownership is more dependent on partner quality than initial pricing.
Where Dynamics 365 delivers strong ROI
ERP benchmarks suggest typical 106% ROI within 12–24 months when implementations are properly scoped and adoption is strong.
In these cases, the system becomes underutilized despite full deployment.
Dynamics 365 sits in a middle position between SAP S/4HANA and Oracle NetSuite in terms of implementation complexity, flexibility, and time-to-value.
The differences are not just technical, but architectural and operational.
| Platform | Implementation Complexity | Time to Value | Key Tradeoff |
|---|---|---|---|
| Dynamics 365 | Medium–High | 6–14 months | Flexible but integration-heavy |
| SAP S/4HANA | High (enterprise) | 9–18 months | Structured but rigid |
| Oracle NetSuite | Medium | 4–9 months | Faster but less flexible |
Across Reddit discussions on Dynamics 365 rollouts, NAV to Business Central migrations, and CRM implementations, the same themes repeat: cost shock, migration complexity, and post-go-live friction.
“Received $400K+ quotes for Microsoft CRM — is this normal?”
Most discussions highlight a gap between expected licensing cost and actual implementation spend, especially when integration and partner services are included.
“It’s closer to a re-implementation than a migration once you factor in customizations.”
NAV and GP to Business Central transitions are repeatedly described as redesign-heavy due to legacy customizations and data structure changes.
“Data migration is where most projects go wrong.”
Practitioners consistently report that data issues only surface during testing, often forcing redesign of reporting and workflows.
“Even when everything works, users go back to Excel.”
A recurring pattern is partial adoption, where teams continue parallel processes due to trust and familiarity gaps.
Key community takeaway:
Across threads, the consistent signal is simple: Dynamics 365 challenges are rarely about the product. They are about data readiness, integration depth, and user adoption after go-live.
A Dynamics 365 implementation succeeds or fails before go-live, based on how well data, processes, ownership, and partner execution are aligned.
Across real-world rollouts, the same pattern appears: budgets strain when decisions rely on licensing alone, timelines slip due to data and integration dependencies, and adoption gaps limit value even when the system works as intended.
Organizations that realize measurable returns from Microsoft Dynamics 365 approach it as an operational shift rather than a software rollout. They phase delivery, prioritize data and integrations early, invest in post-go-live stabilization, and select partners based on execution capability.
Align your Dynamics 365 rollout approach with real implementation constraints across cost, timeline, and adoption.
